Introduction
Agile is often described as iteratively building software in increments. This is a focus on the team and the mechanics of how they work. It is more effective to focus on the reason for being Agile – achieving business agility. Business agility is the ability to deliver highest business value quickly, predictably, sustainably and with high quality. Building software is not our goal, realizing business value is. Software is often a component of this, of course.
Faster “time-to-market” is a well-known mantra. The common trap is to try to achieve time-to-market simply by trying to go faster. The better approach is to focus on what will truly provide the greatest value. Instead of trying to go faster, build those chunks of business value which are most important. Go smaller and focus on those value adds that contain the most value for their efforts.
We call this the “Minimum Business Increment” (MBI). The MBI is a key to delivering value quickly by focusing on the most important business value to realize. It becomes a cornerstone concept in planning and alignment.
Frequency of delivery vs. time to deliver
All too often, organizations cannot deliver value quickly. While deliveries may take place on a quarterly basis, the work being delivered has often been under development for a year. The issue is not how frequently you deliver but rather what is the time frame from start to finish.
Delivering in stages
To set the stage for incremental delivery of business value, it is important to understand why this is so beneficial. Mark Denne and Cleland-Huang put forth some compelling arguments for quick, frequent delivery in their book, Software by Numbers: Low-Risk, High-Return Development.

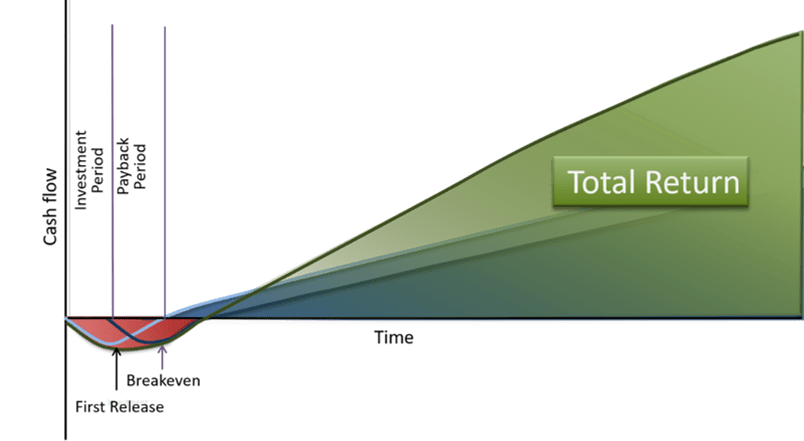

Figure 1 illustrates the economics of delivery they propose. This diagram illustrates how, at the beginning of a software project, the organization loses money during the investment period. After the product is released, there is a payback period and that leads to making enough money to incur profit.

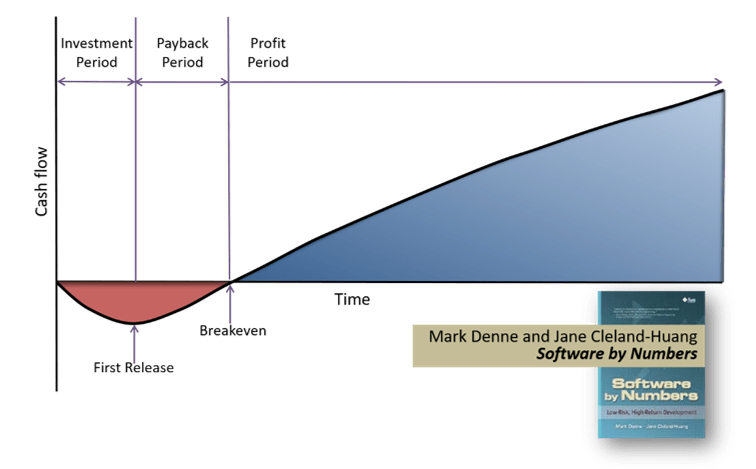

Figure 1: The economics of responsiveness
Consider an example. Suppose you are the CEO of a company that does product development projects for other companies. You have received a Request for Proposal (RFP) that requires 100 features to be done in 10 months with a certain amount of quality and that the price is fixed. Here is what the RFP stipulates.
- You cannot change any of these factors. That is, all 100 features must be delivered by the date, not earlier nor later.
- They must be of the quality specified, not better or worse.
- They must take exactly the money offered, not more nor less.
- All of the factors in the “iron triangle” have been specified: scope, time, and cost (with quality being thrown in as well).
How could you win such a contract? Perhaps if your company had a better track record than the competition, you could win on the basis of credibility; however, let’s suppose that is not the case. How else could you compete?
Consider the rate of delivery.
For example, suppose you commit to delivering 50 features after five months and the other 50 features at the 10 months. You are complying with the requirement to deliver 100 features after 10 months; you are just delivering some earlier. What would this look like economically? Assume delivering the first half of the features cost you half the work and delivered half the value, the investment and return graphs would look something like that shown in Figure 2. Even if these assumptions are not completely correct, let’s explore this simple model and then discuss the issues that must be dealt with to make it more realistic.

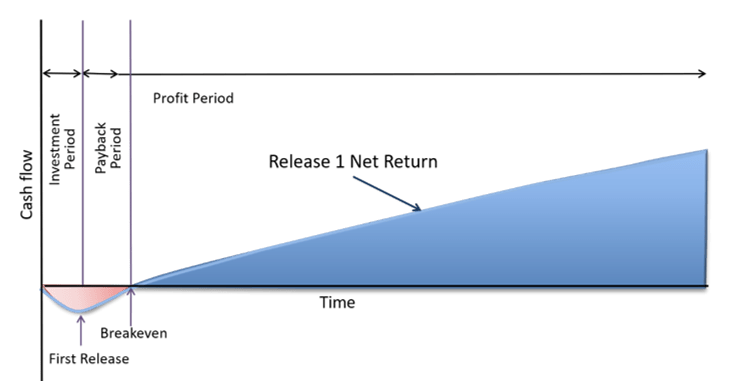

Figure 2. The economics of two releases: Release 1
While you cannot always do this staged release scheme, most software can be delivered in increments. For example, ignore the factors of extra development time for a staged release (which would make the cost curves deeper) as well as extra delivery and consumption costs for a staged release (also making the cost curves deeper). Figure 3 shows the combined cost curves in Figure 2 compared with the cost curve of the single release, the net cost of the stage release is less because the return from the first, partial release, offsets the investment required by the second partial release.
Figure 3: The economics of two releases: Releases 1 and 2
Figure 4 shows the total return that is achieved. Figure 5 compares this phased return with the return from a single release. The top line is the return from the staged releases while the line underneath it is the return from the single release. The reason the investment for the staged release is less is that while the second release is being built the first release is giving us a return.
Figure 4: Total return of the two releases

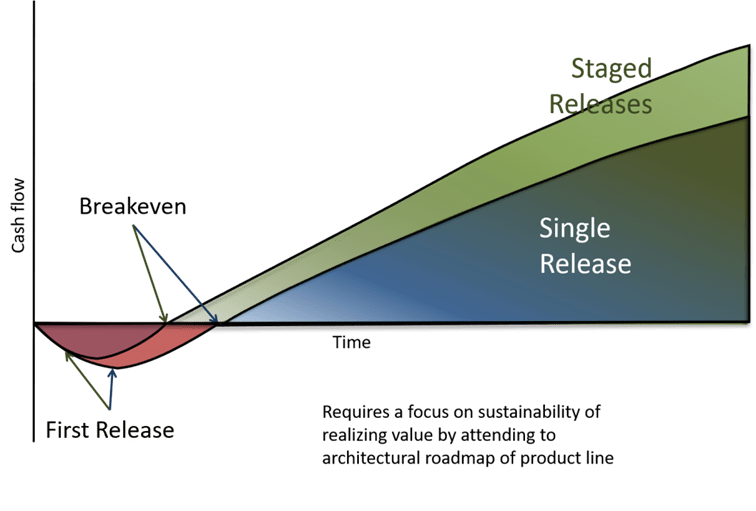

Figure 5: Staged releases vs. single release
While this may have been a contrived example, it illustrates the value of delivering in stages: getting value sooner. In the real world, after the first release we could take advantage of what we learned and pivot if needed. The key is to recognize that the three dimensions often quoted (scope, cost, and time) leave out the fourth dimension of iterative delivery.
The issues of staged delivery
Of course, it is not as simple as this. Building software in stages may take more effort than building it in one pass. Two deliveries may cost more and may be more disruptive for customers. These factors would all take the return curves down by adding more cost. Let’s look at the concerns about extra costs and then consider the advantages of phased deliveries.
Extra cost of building phased deliveries
While some people are concerned about building in stages, it does not need to cost more. If you are extending a legacy system that has large amounts of technical debt and is difficult to test, then multiple deliveries may, in fact, cost more. But if your code quality is good and you have automated tests, it often costs less to build and deliver in stages. There are several reasons that contribute to this. One is phased deliveries can result in not building certain function that at first appears necessary, but with the feedback from the first phase, you learn that it is not as desirable as first thought. Also, the use of emergent design can speed up phased delivery. Emergent design is beyond the focus of this book. For more information, see Scott Bain’s excellent book, Emergent Design: The evolutionary nature of professional software development.
Extra cost of deployment
This can result in extra cost in deployment; however, it does not necessarily have to be so. Making an investment in being able to release and deploy quickly is important so as to take advantage of the extra return it affords.
Extra cost of consumption
While there are some applications in which users do not want updated on a regular basis, studies have shown that most users prefer small, frequent upgrades to large, infrequent ones. The salient characteristic, of course, is the level of disruption to the user. If the cost of consumption by the user is small enough, they won’t mind it. Most objections to upgrades are due to the effort required by the user to do the upgrade.
The potential return of staged delivery
Of course, in the real world, when you can make staged deliveries, you will not arbitrarily pick half the features and release them. Instead, you would pick those features that made the most sense to deliver. This would include looking at the factors such as where is the greatest value and what will it cost to build, deploy, and consume the release. Clearly the smallest release that is useful to the customer and worth the incremental cost of building and deploying is what you should do. We prefer to call this the “Minimum Business Increment” or MBI. Others have used the term Minimal Marketable Feature (MMF), Minimal Viable Feature (MVF), and Minimal Viable Product (MVP).
These are not just name changes. They also indicate intent of the phase. Eric Ries talks about MVPs as a way to test the market – both to see if your product is viable and to gain quick entry. While we talked about how the return curves for a phased release may not be as good as illustrated, there are some other considerations that may make them considerably better. In a highly competitive situation, for example, whoever gets into the marketplace first may capture it.
In this extreme case, gaining entry into the market three months before our competition may enable our client to own it. Coming in two months after their competition may be an effective barrier of entry. Another advantage is that customers will be able to provide greater feedback to improve the effectiveness of the subsequent phases of delivery.
Delivering Sooner When Multiple Projects Are Present
The main idea is earlier delivery. This can also occur when you have one team with multiple projects. In this case it’s worth working on one project, then another and then another until the are done. This provides value sooner than working on all of them at one time. See Figure 6 for a comparison when one team has three projects to work on.

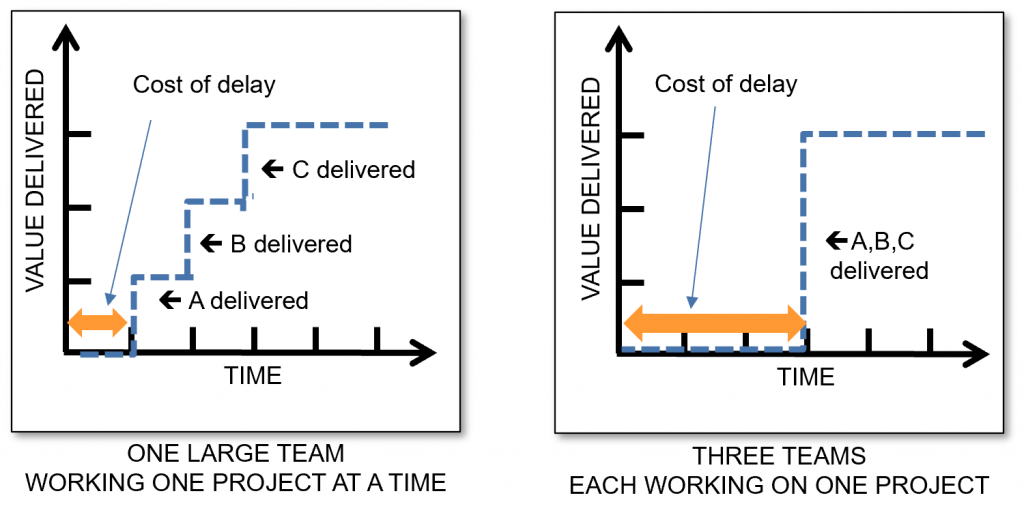

Figure 6: Cost of delay compared when have one large team and three projects
Lowering risks in development
Tie biggest risk in software development has long been building the wrong thing. Or overbuilding the right thing (which basically means some of what was built was right and some of it was not’t as useful. MBIs enable a new type of evolution of products which can dramatically lower the risk of building features of little value.
System evolution
Many applications are built by layer. First a framework is built and then different layers are added until it is complete. We call this “system evolution.” This is shown in Figure 7.

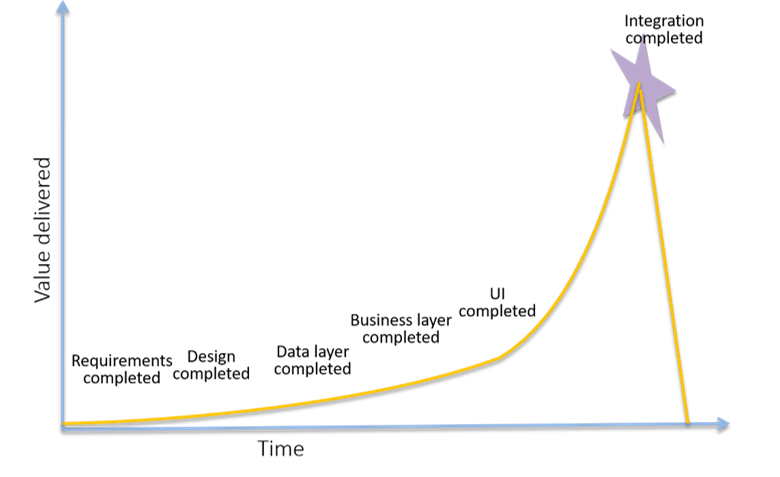

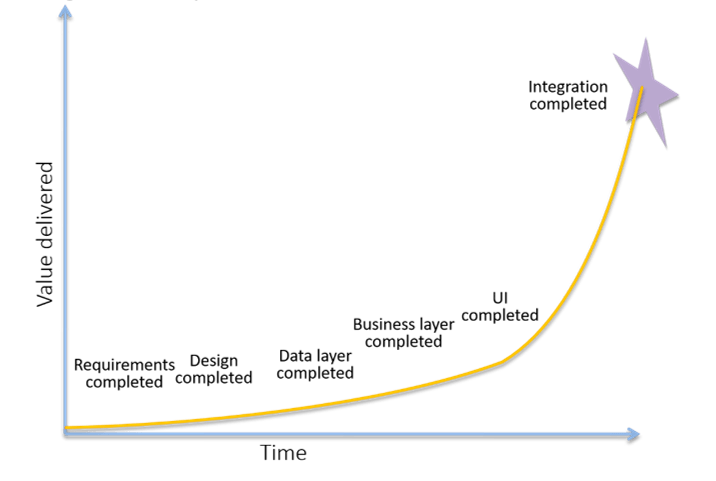

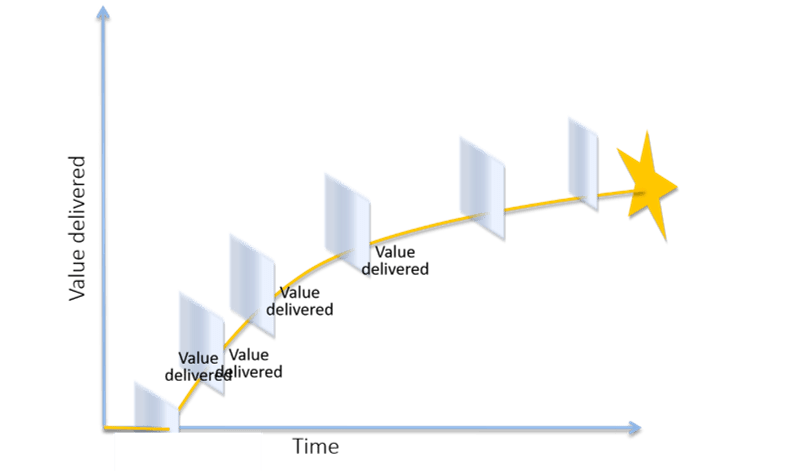

Figure 7: System evolution
In system evolution, the system is built in phases, one on top of another. These can be done in parallel as well but until all phases are done there is no value.
Business evolution
In “business evolution,” you deliver increments of value as soon as possible. This is accomplished by using MBIs. The purpose of staged deliveries is to deliver real value sooner and to stop delivering when enough value has been delivered. Business evolution delivers a series of business increments as shown in Figure 8.

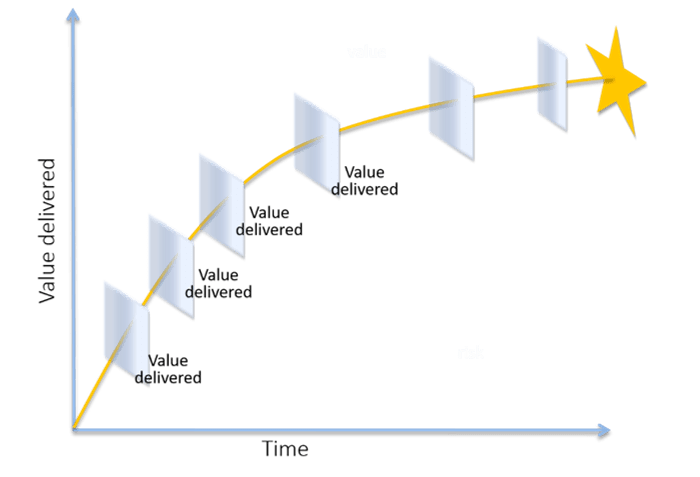

Figure 8: Business evolution
Here are some of the advantages business evolution offers over system evolution.
- Value is realized sooner.
- Customers get to provide feedback quickly on what they want.
- The development team can take advantage of what they learned from early releases.
- Releases of a new product can be delayed when enough value is achieved.
- The risk of spending significant effort on work that does not produce value is lower.
- The second bullet point is important. It is a truism that customers often do not know what they want until they see something… or until after they see what it is they don’t want!
Lowering risk
In both system evolution and business evolution, it is possible to build the wrong thing but the impact is much different. Figure 9 shows what happens in system evolution if the wrong thing is built at the end.
Figure 9: Return when building the wrong thing with system evolution
Business evolution does not guarantee that the wrong things won’t be built; but if that happens, it will be discovered much earlier, as shown in Figure 10.
Figure 10: Return when building the wrong thing with business evolution
Comparing the risks of the two approaches
Consider the risks involved in system evolution and business evolution. Figure 11 illustrates the potential risk curves of each approach. Both start with the same risk and both end with no risk (that is, when it is finished, everything is finished and there is no more risk involved). Compare the risk curves in each approach. What are the implications if risk and uncertainty start out high and stay high until the end or go down at a steady pace over time or go down quickly?

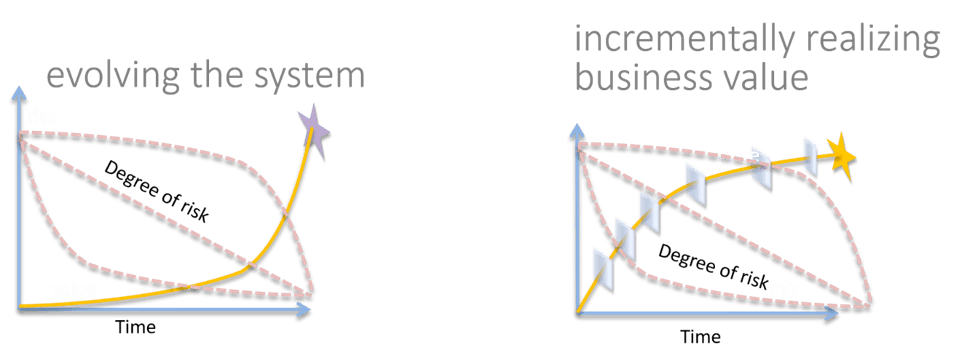

Figure 11: The possible risk curves for system evolution and business evolution
In system evolution, the risk comes from not getting good feedback from the customer until the very end. You run the risk of building the wrong thing, of over-building the system, or even of building the architecture for the system incorrectly. By contrast, in business evolution, you find out early if something is going wrong and you can make adjustments. As Figure 12 shows, in business evolution the risk goes down significantly with the first release.

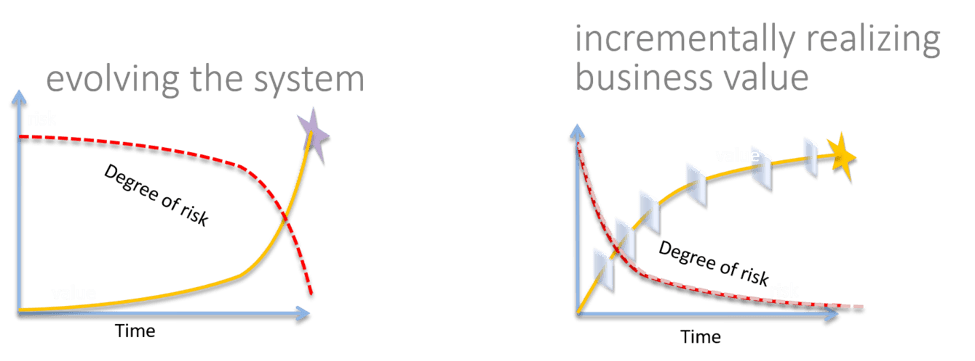

Figure 12: The actual risk curves for system and business evolution
Opportunities and the need to lock across products
Both XP and Scrum bring a focus on the interaction between the team and the customer. This is appropriate when teams are independent and work in only one area. In larger organizations, a broader view is needed. Within that broader view, the focus of the team to the customer is good so long as the context is not ignored.
To understand this, consider the different possible rate of returns you can have on projects. The ideal case is what is called the “Pareto Curve.” This occurs when 80% of the value is achieved by doing 20% of the work. The challenge is that Product Owners are tasked with continuously building the product they are responsible for. With system evolution there is a tendency to build all that has been asked for. But with business evolution the Product Owner can see if most of the gains have been achieved and that a new project should be started. For example, in Figure 7 it is possible that another project could be worked on after the fourth release.
Although customers who are using this product may want you to continue working on this, you run the risk of missing opportunities for other products that can give a big return on its first release. In other words, instead of getting the tail end of the Pareto Curve, you may want to look for other products that will give a big return for relatively little effort.
We often see budgeting errors in this situation. For example, companies continue to provide funding for established products because they base budgets along the lines the returns are occurring in. The better approach is to have budgets made along the lines of what future returns would be available. Of course, it is important to consider what will happen to existing systems if they are not enhanced over time. But even this involves looking at investment on the basis of future returns rather than on past laurels or on the idea that a team belongs to a customer.
Looking forward in this way opens up the opportunity for better product portfolio management. You can pick those features, regardless of which product they are for, that produces the greatest value to the organization.
Finally, it is good to note that not all products give such a Pareto return. Many give fairly linear results with each release providing an amount of value proportional to the effort it took to achieve it. Some product enhancements return value relatively quickly; others take a few months to build. You want to avoid long delays in realizing value simply because you did not consider the potential of incremental business delivery.
