Project management

using data to increase profitability and reduce risks

Why Project Accounting?

Accounting for Knowledge Workers in the New Millennium

In the knowledge economy, understanding production costs requires a new approach.

The era of manufacturing and farming is giving way to one of knowledge work. This is old news in the U.S. but, in our lifetime, the changes the developed world is currently undergoing will be experienced by the vast majority of humanity. Eventually, nearly everyone will be some sort of knowledge worker.

Companies like Wal-Mart, Dell, and Archer Daniels Midland exemplify how well the problem of materials management is already solved. Knowledge, process and project management, however, are still relatively nascent fields.

Out of our 30-millennia history, only in the last 50 years have we seen the cost of knowledge workers rise to be a significant portion of the economy. In Texas alone in 2003, 48% of the workforce fell into the knowledge worker category. These numbers are growing and will, in our lifetime, encompass the majority of workers globally. Think about what your parents and grandparents did for a living. Chances are they were farmers or factory workers for at least a portion of their careers, not knowledge workers. (Greenfield, 2006)

Project Accounting is how we understand production costs in a knowledge economy.

So why all this interest in project and portfolio management, time tracking and project accounting solutions? Our hunter/gatherer ancestors implicitly knew the costs of doing business. Materials-oriented businesses, like manufacturing and farming, have had adequate accounting systems for thousands of years.

The knowledge worker-dependent businesses of today, though, are relatively new and for the first time since accounting was invented by Babylonian farmers thousands of years ago, nobody knows their costs. If you don’t know your costs, you don’t know where you’re profitable. And if you don’t know where you’re profitable, you can’t steer your company to success.

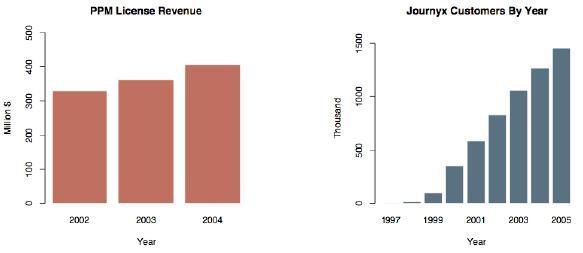

As shown in Exhibit 1, demand for project and portfolio management solutions, which often incorporate some project accounting abilities, is growing at 11% annually.

PPM License Revenue and Journyx Customers By Year (Journyx, 2006)

Exhibit 1: PPM License Revenue and Journyx Customers By Year (Journyx, 2006)

What is Project Accounting?

Project accounting is the practice of creating financial reports specifically designed to track the financial progress of projects, which can then be used by managers to aid project management.

Impediments to Success

The biggest impediment to success in project accounting is employee resistance to data collection. But why do people hate to track their time so much?

Reason #1 Reporting time can threaten status.

For salaried people, especially if they have been employed earlier in their life in an hourly “time clock” environment, reporting time can make them feel demoted. Conventional wisdom (with which this author disagrees) is that “professionals” are more trustworthy and less in need of supervision than “blue collar” people.

Reason #2 “What if I find out that I don’t work as much as I like to think?”

Some people - often the most productive - garner self-esteem from the large number of hours they work. But sometimes they’re not sure if they believe their own braggadocio and the thought of finding out the truth is scary.

Reason #3 Time is a bad metric for effort or productivity.

Knowledge workers know that managers, who have the power to reward some people over others, often forget the vague and aggregated metrics of real productivity in favor of some simple numbers that are tangible, like time records. Managers may take the easy path of rewarding based on time spent rather than develop more subtle and appropriate metrics of real productivity (hint: don’t do this).

Reason #4 “I’m too busy”

The busiest, most responsible employees - the productive ones whose time is in highest demand - will, sooner or later, always have to stop doing the primary mission of the company to fill out a timesheet. The star employees tend to procrastinate when it comes to this task, or even outright refuse to do it. Worse still, they may unintentionally create flawed records. Meanwhile, the malingerers and marginal producers will often create perfect time records and never submit them late. This creates an impression in the minds of both that the whole exercise is worthless.

Remedies for Impediments

Education and Buy-In

The most effective way to get people to do anything is to make sure they understand what’s in it for them. In the case of payroll for hourly workers, since they want to get paid, it’s easy. In the case of billing automation, it’s revenue for the company. Most people can understand this because most people care if their company succeeds.

Project accounting is more abstract. Bad project accounting leads to unnecessary overtime, stress, blown schedules, bad estimates and cancelled projects. Citing specific examples from your company’s history where accurate time collection could have made things easier for your employees helps to get them on board.

Adoption Dashboard

Journyx Timesheet includes graphs that make clear to managers which departments and people are entering their time consistently and completely and which are not. This information helps managers understand early who they need to push on (to the degree a top-down approach works in the company’s culture).

Incentives

Tying bonuses or other benefits to complete data collection is often used in customer relationship management (CRM) tools to adjust sales commissions. The same can be done for other forms of data collection. Journyx has a patent – we call it the ‘frequent flyer patent’ – for rewarding employees (on your behalf) for logging time and expense data in a timely manner.

Phased rollout

Adopting a multiphase rollout approach that leads to per-person per-project profitability allows you to affect the culture in more manageable steps.

Email Reminders

Getting an automated reminder when your time has not yet been recorded produces results… usually.

Implementing Project Accounting

If you have more than about five people in your organization and they are working on multiple projects or within many processes, it is time to start thinking about implementing time tracking. If you have 100 people in an R&D group and you’re not tracking time, then you’re wasting the lives and work of a significant percentage of your employees. Odds are you have them working on projects that the market isn’t interested in, or that are over-budget or otherwise in the ditch -- and you don’t even know it.

In his book “The Seven Habits of Highly Effective People,” Stephen Covey (1989) argues that you should track your time even if it’s just for yourself. If you do you will certainly be surprised by the data; however, we have found that the business value is really delivered in terms of understanding profitability for organizations of at least five people.

If you’ve decided that it makes sense for your company to get started with time tracking, follow this five-step process to reach time-tracking Nirvana. Guiding your company forward to a tracking environment requires changes to your corporate culture. Start by explaining the benefits of doing this to the company. If you understand your costs, you can run your business. Otherwise, you’re flying blind.

Level 1 - Chaos

Most knowledge worker companies today are at this stage. If they’re a business services company, their client billing is inaccurate. If they’re an IT division of a large firm, they do not know which projects are enhancing the value of the company and which are destroying it - therefore they cannot run their division like a business.

What to do to improve

Create a complete authoritative master list of the projects or processes whose costs you want to understand, along with a list of the employees that spend their time on that work. Begin with the end in mind. What will the reports that you want to get out of the system ultimately need to look like? Decide who will own the system and begin populating the system by adding new employees and projects to it. Get most of your people to start tracking time.

Level 2. Most of your people are tracking most of their time

Benefits - Now you have a basic idea of how your resources are spending their efforts and it will produce some surprises. Now that you’ve entered data in the system and employees are tracking their time, you have an accurate and complete list of your company’s projects. Say, for example, you review the data and see that some projects have more time spent on them than you expected. Or you may find that ‘fun’ projects and maintenance activities are getting more attention from more people than you realized. Real data has already surprised you.

What to do to improve

Start measuring adoption by seeing how many employees you can get to track their hours and how often they enter it. Your data will be best if people track their time daily or even more frequently. Recording what you did a week ago is useless. Who remembers what they ate for lunch last Thursday? Next - Get everyone tracking time and expenses with pay rates. Now it’s time to guide your company to the next level. Compute a pay rate for each person in the company and enter it in the system. Ask employees, where appropriate, to record mileage and travel expense data. Further encourage your entire employee base to track their data.

Level 3. Direct costs are known

You now know your per-project-per-person direct cost data. Your estimation ability has improved dramatically through the ability to conduct data-based post mortems of projects. From a cost perspective, you can begin to run your organization like a real business to a real extent.

What to do to improve

Provide for calculations of indirect costs and choose formulas for spreading that cost. Expenses incurred in your company in areas like accounting, marketing, office space, and other general and administrative expenses can be organized by project cost, project revenue, per person, by square footage of office space used, or one of countless other ways. Often, two levels of indirect cost may be necessary. For example, if you are a business services company and have a customer for whom you are doing multiple projects, then you may have some partially indirect expenses that apply to that customer, but not for any specific one of his projects. There should be a formula for spreading that ‘partially indirect’ cost over more than just that one customer’s projects.

Level 4. Now you know total cost on a per-project basis as well as total cost on a per-person-per-project basis

Benefits – Knowing the exact costs including the indirect costs of management and such things on every project and person allows you to understand which projects need help, which people are misallocated, and it shines a strong light on overhead costs. You have much of the data you need to improve your company’s future.

What to do to improve

It’s time to connect costs to revenue and then get profit.

Level 5. Revenue Integration

Tools like Salesforce.com or SugarCRM (or similar sales force automation technologies that record closed sales) provide a great way to track bookings (depending on your business, even revenue). Integrating your time accounting system into these systems can give you a profit report (or an approximation of one). Integrating the system into QuickBooks, SAP or other accounting systems can connect time periods for revenue recognition to cost, giving a good estimation of profit on a per-person-per-project basis. For R&D departments or IT organizations or other knowledge worker organizations internal to a company, proxies for revenue like business value delivered can be used. Exhibit 2 shows the above mentioned functions of time tracking data.

You’ve now reached time tracking Nirvana - per-person-per-project profitability measurement. And at every step, your situation is better than it was before.

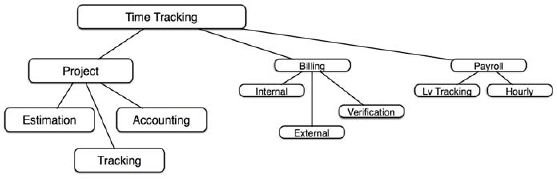

Functions of Time Tracking Data

Exhibit 2: Functions of Time Tracking Data

Functions of Time Tracking Data

Time for Projects

Project Estimation

Using time and expense data from similar past projects to predict future project costs and schedules.

Project Tracking

Knowing how close to “done” a project or subproject is.

Project Accounting

Understanding the cost to date of a project.

Time for Billing

Internal Billing

Creating split bills to departments within your company that are using your services.

External Billing

Billing clients, sometimes exorbitantly.

Billing Verification

Proving that contractors and outsource personnel have sent you accurate bills.

Time for Payroll

Salaried Payroll

Leave tracking.

Hourly Payroll

Overtime calculations, punch rounding, lockouts.

The Future of Project Accounting, Probably

What will the future of project accounting look like?

The Achilles’ heel of project accounting is data collection -- mainly time tracking. The Achilles’ heel of time tracking is compliance and adoption. Journyx has built-in email reminders and adoption dashboards to alleviate that problem somewhat.

Further, we’re working on speech input, PDAs, and integrations with popular tools – like call-center software and cash registers – in specific industries to gather time records automatically. We’ve also launched on-demand web sites so you don’t have to install anything more than a web-browser (or convince your cranky IT people to help you).

This last development is particularly intriguing. The software industry has begun a shift from customers installing software at their physical locations to renting web-based software over the internet on a monthly basis. It’s moving this way because customers want it to, and so do the most of the reputable vendors.

Most software companies get their revenue from “shelfware” (software that is rarely used and ends up on the proverbial shelf). Popular programs - from Quicken to SAP - for which customers pay the total cost up front - can be complicated, making them difficult to use and achieve maximum benefit from. However, once a customer has paid for these programs, there is little incentive for the company to follow up and ensure that it is working properly for the customer.

But things may be improving. Companies like Journyx, KaleidaCare (foster care automation) and Affiniscape (association management) are quite successful in renting software over the web to their customers. If customers sign up for a monthly service from one of these companies and the solution doesn’t work, customers will likely stop using the software after a month. This gives these software providers incentive to pay attention to customer usage, understand whether or not the technology is providing business value, and strive to increase its value. With this model, everybody wins because interests are more aligned.

And that’s a future everyone will profit from.

Covey, S. (1989) The 7 Habits of Highly Effective People. New York: Simon and Schuster.

Greenfield, S. (2006) Personnel Predicament: The Coming Human Resource Crisis in Texas Government. Retrieved from http://utopia.utexas.edu/articles/tbr/personnel.html?sec=business&sub=management

© 2006, Curt Finch
Originally published as a part of 2006 PMI Global Congress Proceedings – Seattle Washington

Advertisement

Advertisement

Related Content

  • Project Management Journal

    People as Our Most Important Asset member content locked

    By Dupret, Katia | Pultz, Sabrina In this article, we examine how employees experience different types of work commitment at an IT consultancy company using agility to give staff greater autonomy and decision-making latitude.

  • Thought Leadership Series

    Sainō no gyappu o sebameru member content open

    PMI to PwC no saishin no sekai-tekina chōsa ni yoru to, purojekutobēsu no soshiki no ma de, zento ni yokotawaru risuku, oyobi jinzai kiki ga purojekuto to senryaku o mitasu nōryoku ni oyobosu…

  • Thought Leadership Series

    Suōxiǎo réncái chājù member content open

    PMI hé pǔ huá yǒng dào zuìxīn de quánqiú yánjiū biǎomíng, jīyú xiàngmù dì zǔzhī quēfá duì wèilái fēngxiǎn de rènshí, huòzhě kěnéng yǒuxiē zìmǎn, yǐjí réncái wéijī jiāng duì xiàngmù jí qí mǎnzú…

  • Thought Leadership Reports

    Combler le fossédes talents member content open

    PMI and PwC's latest global research indicates there is a lack of awareness, or perhaps some complacency, among project-based organizations of the risks that lie ahead, and the potential detrimental…

  • Thought Leadership Reports

    Die Talentlücke verkleinern member content open

    PMI and PwC's latest global research indicates there is a lack of awareness, or perhaps some complacency, among project-based organizations of the risks that lie ahead, and the potential detrimental…

Advertisement
