How PRINCE2 can compliment PMBOK® guide and your PMP®

Abstract

A Guide to the Project Management Body of Knowledge (PMBOK® Guided is the recognized (de facto) standard of project management knowledge. In the UK and Europe, PRINCE® is the project management methodology of choice, and is required by the UK government for all projects it commissions. This paper will provide an overview of the PRINCE2 method and examine the similarities and differences between PMBOK® Guide and PRINCE2. Finally, it will suggest how these two project management approaches relate to and can complement each other, and how the PRINCE2 approach can provide added value to a PMBOK ® Guide knowledge base.

About PRINCE2

PRINCE2 (short for “PRojects IN Controlled Environments”) is the de facto standard in the UK. It was developed for and is used extensively by the UK government, and is widely used in the private sector, in the UK and internationally. PRINCE2 is in the public domain, offering non-proprietary best-practice guidance on project management. Anyone may use this methodology, and the manual describing PRINCE2 can be purchased through online booksellers, as well as through the UK government website, http://www.ogc.gov.uk/prince. PRINCE2 is supported by a rigorous accreditation process, including accreditation of training organizations, trainers, practitioners, and consultants. (The accrediting body is the APM Group, www.apmgroup.co.uk; their website lists approved training organizations, consultants, and practitioners.)

PRINCE2 is a Process-based, structured methodology that highlights how eight particular Components, when understood and effectively addressed, can additionally reduce risks in all types of projects. While PRINCE2 is based in the same ground as the PMBOK® Guide, it spotlights a number of areas to concretize PMBOK® Guide, and answers the question “how do I apply these concepts in my projects?”

The Structure of PRINCE2

PRINCE2 does not claim to be as comprehensive as the PMBOK® Guide. PRINCE2 is based on the principles of the PMBOK® Guide, as any project management methodology must be. PRINCE2 extracts and focuses on the elements (“components”) which it identifies as being crucial to the successful assessment and completion of a project. It constructs a process to tie those elements together to reduce overall project risk, and provides techniques to support them. While “The PMBOK® Guide” offers a loose, general approach to integrating the Knowledge Areas, PRINCE2 suggests an effective way to organize them. In essence PRINCE2 says: “using these elements in this way is the most effective way to reduce project risk and maintain quality within the project.”

PRINCE2 components and processes are consistent with the PMBOK® Guide, but PRINCE2 does not include all the knowledge areas and details specified in the PMBOK® Guide. PRINCE2 focuses on critical areas, so a project manager still needs to draw on the full depth and range of the PMBOK® Guide and other sources to complete project management work. The intention of PRINCE2 is to organize and supplement project management knowledge. It assumes that those learning and working with this methodology have a level of experience that enables them to fill in the details that PRINCE2 omits. In PRINCE2 the scale and content of its Processes, Components and Techniques should be adapted to the size and nature of the project.

PRINCE2 Components

PRINCE2 is comprised of 8 elements, or “components”. They are: Business Case, Organization, Plans, Controls, Management of Risk, Quality in a Project Environment, Configuration Management, and Change Control. They roughly map against the PMBOK® Guide Areas of Knowledge as follows:

Comparison of PMBOK® Guide Areas of Knowledge and PRINCE2 Components

Exhibit 1 – Comparison of PMBOK® Guide Areas of Knowledge and PRINCE2 Components

These components are not as comprehensively defined as the Areas of Knowledge. For example, PRINCE2 covers PMBOK® Guide's Time and Cost Management within its discussion of Plans—but only insofar as the development of time and cost information is necessary at the relevant plan level. The following summarizes the PRINCE2 components:

Business Case: The existence of a viable Business Case is the main control condition for a PRINCE2 project. The Business Case is verified by the Project Board before a project begins and at every major decision point throughout the project. The project should be stopped if the viability of the Business Case disappears for any reason.

Organization: Since the Project Manager often has to direct staff who report to another management structure, some senior management oversight organization is needed to assure that those diverse resources are committed to the project. In addition, viability decisions need to made by management with an investment in the project, and an accountability for delivering it through the Project Manager. In PRINCE2 this oversight is the Project Board.

Plans: Plans are the backbone of the management information system required for any project, and require the approval and commitment of the appropriate levels of the project organization. The “Plans” component emphasizes the core concepts of planning; the major steps are highlighted in the process model, in “Planning.”

Controls: Control is about decision making: its purpose is to ensure that the project (a) is generating the required products which meet defined Acceptance Criteria; (b) is being carried out to schedule and in accordance with its resource and cost plans; and (c) remains viable against its Business Case.

Management of Risk: As project work is inherently less predictable than non-project work, management of the risks is an essential part of project management. To contain risks during the project, they must be managed in a disciplined manner, through risk analysis and risk management (as in the PMBOK® Guide).

Quality in a Project Environment: Quality management ensures that the quality expected by the customer is achieved through a quality system (similar to the PMBOK® Guide). Quality requirements of the project's deliverables are based in Product Descriptions, prepared by the Project Manager and approved by the Project Board.

Configuration Management: Configuration Management gives the project management team control over the project's assets (the products that it develops), and is vital to any quality system. It provides mechanisms for tracking and controlling the project's deliverables, and a system for tracking project Issues.

Change Control: Controlling scope change means assessing the impact of potential changes, their importance, cost, impact on the Business Case, and a decision by management on whether or not to include them.

None of the above components will be alien to a user of the PMBOK® Guide—PRINCE2 simply highlights these elements as being central to project success, often under-addressed by project managers. The PRINCE2 methodology organizes these components into a process model, recognizing that flow and relationship are critical to successful use of concepts identified in the components (and Knowledge Areas).

PRINCE2 Process Overview

PRINCE2 Stages

To provide the appropriate decision gates at the right level of the project, PRINCE2 projects are broken down into Stages, much like the Phases of the PMBOK® Guide process model. PRINCE2 calls for decisions about the project as a whole to be made prior to looking at any developmental work. PRINCE2 differentiates the start up, planning and close for the overall Project (“Starting a Project,” “Initiating a Project” and “Closing a Project”) from the activities to start up and close down each of the Stages (“Managing Stage Boundaries”).

The actual Executing and Controlling of the developmental work (from Feasibility or Requirements onward) shows up at the Stage level, through “Controlling a Stage” and “Managing Product Delivery.” Project oversight (by the Project Board) occurs throughout the project through “Directing a Project.” “Planning” is a generalized process that is accessed at all levels of the project, as needed.

The PRINCE2 Processes (refer to Exhibit 2 for the context of each process.)

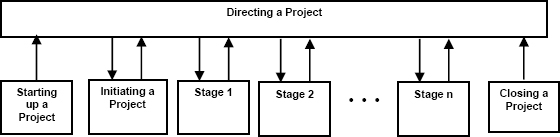

PRINCE2 Process Model

Exhibit 2 – PRINCE2 Process Model

“Starting Up a Project” enables a controlled start to the project. It occurs once in the project life cycle, providing the groundwork for project management and oversight, and viability evaluation. This process creates the Project Board, and ensures that resource requirements are understood and committed to the first Stage, “Initiating a Project”.

“Directing a Project” operates throughout the project, and defines the responsibilities of the Project Board in its oversight of the project. Like its location in the process model diagram, it sits above and interacts with many of the other processes. It provides the mechanisms for authorizing the project, approving continuity at the completion of each Stage, and closure of the project (all based on the Business Case). “Directing a Project” is the framework for supplying input to the project manager, receiving requests from the project manager for information and assistance, and making decisions. This is the only process in which the Project Board is active (other than “Starting Up a Project,” when the Board is first formed). All other processes are guided by the Project and Team Managers.

“Initiating a Project” occurs once in the project life cycle. It lays out the view of how the overall project is to be managed, and sets it down in a “contract” called the Project Initiation Document (PID). The intention of the PID is to provide a common understanding of the critical elements of the project (similar to the results from PMBOK® Guide's Planning process). “Initiating a Project” also calls for resource commitment by the Project Board to the first developmental Stage of the project.

“Planning” is the common process for several other processes in PRINCE2. Plans are produced by identifying the project's required deliverables, the activities and resources necessary to create them, and the management and quality requirements – all at a level consistent with the control requirements identified in the PID. Use of a common module highlights the concept of a consistent, coherent approach to all planning.

“Controlling a Stage” provides guidance to the Project Manager in managing the project on a day-to-day basis. It includes: work authorization and receipt of work; issue and change management; status collection, analysis and reporting; viability consideration; corrective action; and escalation of concerns to the Project Board and other resources. “Controlling a Stage” is iterative, and is repeated for each developmental Stage of the project.

“Managing Product Delivery” is part of PRINCE2's work authorization system. It is the mechanism for the performers of technical work (teams, individuals and contractors) to agree on work to be performed, report on progress, complete the work, and return it. It occurs as frequently as work packages are authorized.

“Managing Stage Boundaries” manages the transition from the completion of one work Stage to the commencement of the next Stage. It includes assurance that work defined in the Stage has been completed as defined, provides information to the Project Board to assess the ongoing viability of the project (done in “Directing a Project”), develops plans for and obtains authorization for the next Stage of work, and records lessons learned.

“Closing a Project” is the mechanism to transition the project back to the organization. It closes out the project, whether closure is precipitated by completion of the work, or premature termination. In either event, “Closing” picks up lessons learned and project experiences for organizational records. For completed work, its goal is to ensure that (a) the work has been completed to the Customer's and Management's satisfaction, (b) all expected products have been handed over and accepted by the Customer, and (c) arrangements for the support and operation of project products are in place.

PRINCE2 does not have “core” and “facilitating” processes; all components and processes are integrated into a single flow, which clarifies the relationships among all of them.

The Strengths of PRINCE2

PRINCE2 has a number of impressive and useful features that distinguish it from other project management methodologies. Its strength lies in its common-sense approach. Each of the following features supplements what the PMBOK® Guide provides—through a very specific focus, or by offering a perspective beyond the PMBOK® Guide.

Organization and the Project Board

Perhaps the most significant of PRINCE2's features is the concept of the Project Board. PMBOK® Guide refers to a ‘project sponsor’ in general terms, and suggests the role the sponsor should be playing in supporting the project. PRINCE2 is more specific—it calls for a Project Board to provide oversight and support in a clearly delineated way. (While PRINCE2 does not require the use of any particular feature—such as a Project Board—it does spell out the most robust way to apply that feature, in a manner that would do most to reduce overall risk to the project.)

In most projects, “authority” (the control of resources) is separated from “accountability” (consequences of success or failure): senior management has authority (but often not held accountable for success or failure of the project), while the project manager is held accountable (with insufficient authority over the resources to ensure completion of work). PRINCE2 calls for an accountable Project Board to own the project, helping to ensure their commitment to getting the work completed. At the same time, the Project Board grants authority to the Project Manger by explicitly committing resources as the project progresses. The PMBOK® Guide suggests this will happen under certain organizational structures; PRINCE2 believes it can be implemented in most environments.

PRINCE2 proposes management oversight from those who are in the best position to make decisions about project viability. The Project Board is based in representation from the Business (speaking for how the project will benefit the organization as a whole), the User (for value and usability of the project on a functional level) and the Supplier (for those who will deliver the solution). These are the roles that can assure the availability of resources (if they are at the proper organizational level), and are the kind and level of resource that a project manager needs to resolve issues that arise during a project. Supporting the project manager is part of the Board's role—giving the project manager access to and authority in the parts of the organization needed to ensure success.

The process model calls for the Board to be identified early on, in “Starting Up a Project”. PRINCE2 understands that if a Project Board cannot be assembled to represent the above interests (Business, User, Supplier), it is unlikely that there is sufficient support for the project to succeed. (This is an example of how PRINCE2 ties together what has to be done with why with when it should be done to be most effective.)

Business Case-based decision-making

The Business Case (focusing on the entire scope of change to the business that is affected by the project) is a PRINCE2 component, but its importance cannot be overemphasized. Responsibility for the Business Case belongs to the Project Board and the Project Manager. The Project Board creates and owns the Business Case; the Project Manager provides the information that enables the Project Board to evaluate it and also ensures that the Business Case is considered in project decisions. PRINCE2 drives home the notion of explicit go/no-go decisions—based on the Business Case—in the start-up and initiation of the project, and at the end of each Stage (see Exhibit 3).


Exhibit 3 – Business Case Review (in “Directing a Project”) by the Project Board

Product-Based Planning

The initial element of PRINCE2's Product Based Planning technique—the Product Breakdown Structure—echoes PMBOK® Guide's Work Breakdown Structure in identifying the constituent parts of the project deliverables. PRINCE2 continues the logic of focusing on deliverables (since they are the goal of the project, not the activities), by providing an additional step to this technique: explicating those deliverables through Product Descriptions. PRINCE2 calls for a Product Description (for each product/deliverable for which it is needed), comprising these important characteristics: why it is being created; what it is made up of; the source of materials and the tasks needed to create it; what it should look like when it is done; the resources and skills needed to create it; the criteria for accepting it; and how we will make sure that it meets its criteria.

These traits shape and clarify expectations, and help assure the right product will be created the first time around, not shaped by afterthoughts. These elements together also serve as a baseline reference for changes to the Product. The thoroughness of PRINCE2's Product Descriptions vigorously supplements the PMBOK® Guide's approach. This emphasis on Product Descriptions helps ensure that a sound and agreed basis is established for scope management, earned value management, and quality management. Product Descriptions provide clarity for time and resource estimates, and risk management, and they are the core of Work Packages.

Issue Management

One core principle of quality management is that important information should not get lost; PRINCE2 also reminds us that management of Issues is critical to any quality system. PMBOK® Guide makes reference to the existence of issues that need to be managed, but no mechanism or approach for managing them. PRINCE2 recommends the use of a Log showing details of each Issue: description, evaluation, decisions about it and status. For the “when” of Issue management, PRINCE2 particularly recommends identifying, updating and reviewing Issues during the execution process (“Controlling a Stage”) and at the completion of each Stage (“Managing Stage Boundaries”). No project methodology could qualify for “maturity” without an Issue Management process in place.

Work Packages

The Work Package is the definitional element of PRINCE2's work authorization system: the packet of information relevant to the creation of one or more deliverables (products). It contains one or more Product Descriptions as the core of the work to be performed. PRINCE2's Work Package also details any constraints on production such as time and cost, interfaces and confirmation (between the Project Manager and the resource slated to deliver the Work Package) that the work can be done within those constraints. Work Package contents may go further, providing: risk information; suggested (or required) tools, techniques or standards to do the work; how work is to be reviewed, checked and approved; how work is to be returned; and how issues, problems and status are to be handled and reported. The Work Package becomes a mini-PID (Project Initiation Document), conveying the project's requirements to performers of the work. As with other PRINCE2 tools, this product will vary in content and in degree of formality—ranging from verbal directives to formal written instructions for contractors. The recommended content provides a more comprehensive description of the work to be done than the PMBOK® Guide, along with the mechanism to ensure that completed work will meet expectations on all levels. (PRINCE2 also links the Work Package into its relevant processes: “Controlling a Stage” manages Work Packages from the Project Manager's side; “Managing Product Delivery” handles them from the side of those performing the work.)

Exception Management

In PRINCE2, the process for handling exception situations is defined before execution, in the PID. The Project Board is not designed to micro-manage, but they will have a greater level of comfort with the Project Manager if agreement is made in advance as to where the Project Manager's discretion lies. PRINCE2 provides for interactive communication: “Taking Corrective Action” and “Escalating Project Issues” from the Project Manager's side (“Controlling a Stage”), and “Giving Ad hoc Direction” from the Project Board's side (“Directing a Project”). The Project Board sets performance thresholds through the concept of “Tolerance,” which grants the Project Manager discretion to execute work within agreed time and costs limits. Tolerance is set when planning the overall project (“Initiating a Project”) and for each Stage of the project (“Managing Stage Boundaries”); the Project Manager monitors against Tolerance while “Controlling a Stage.”

Change Control and Configuration Management

Both of these features are identified as components—PRINCE2's way of saying “many people overlook these because they seem complicated, but they can be straightforward and have significant value in reducing project risk.” PRINCE2 makes both of these understandable, in what they are and how to use them. PRINCE2 ties them together: Change Control explains and demonstrates how to manage change requests, while Configuration Management manages the cataloging, tracking and actual changing of the deliverable.

The basic Change Control technique can be used as-is for the simplest of projects, or enhanced to use in a complex environment. Configuration Management does more than manage the change. It provides specific techniques to control project deliverables, including suggested Configuration records and the recommendation to use a Configuration Librarian. What is important is that Change Control and Configuration Management are required parts of any complete (ISO9001-certified) quality management system. As PRINCE2 is consistent with ISO9001, they have been included and integrated with the rest of PRINCE2.

Quality Reviews

The PMBOK® Guide spends extensive time on quality control, and numerous tools and techniques for accomplishing it. They are largely geared towards a physical product environment. Virtually all internal project deliverables (those needed to manage the project itself) and many of the intermediate and client-centered deliverables, however, are text- or graphics-oriented (reports, web sites, specifications, etc). PRINCE2 provides an excellent, tested technique for doing quality control on such products—the Quality Review. It lays out the steps and resources needed to assess the conformance of such deliverables, using Product Descriptions as the basis for evaluation. Techniques like this, to provide guidance on handling this challenging quality situation, are difficult to find. This technique can be lifted as a whole and used in any project environment (a capability shared by many aspects of PRINCE2).

ISO9000 and Project Maturity Models

Many organizations have become focused on bringing their project management up through maturity models (such as OPM3, Capability Maturity Model, and others). At the same time, they find themselves believing they have to invent a new methodology that will provide the backbone for the project management dimension of this undertaking. PRINCE2 was constructed to be in conformance with ISO9001 requirements from its inception, so it becomes a valuable reference—or core—for the development of the project management aspect required by all these maturity models. Its “open” (non-fee) availability means companies do not have to make huge capital investments to build a methodology from scratch, or buy one (often very costly) from a vendor.

Combining the Best of PMBOK® Guide and PRINCE2

PRINCE2 is not meant to stand on its own and needs experience and the depth of PMBOK® Guide to fill it out, so it makes most sense to study the PMBOK® Guide and get a Project Management Professional (PMP®) Certification first. But after Project Managers receive their PMPs, they often ask “Where do I start? How do I put all of this together to actually run a project?” PRINCE2 becomes useful at this point, because it can shape and direct that knowledge. Here are several approaches to getting value out of PRINCE2. PRINCE2 was designed in an integrated manner, so a project manager can get the most out of it when it is used in its entirety. But there are elements of PRINCE2 that can be lifted and applied directly in any project environment. Neither of these approaches requires deviating from a “PMP” or “PMBOK® Guide” environment.

Use it for its unique approaches and insights into project management. Read the PRINCE2 manual, or read the manual and take a PRINCE2 course. Get a grasp of how the “package” as a whole works. Focus on the elements that can be most easily transplanted into your current environment. The most straightforward elements are: Product Descriptions, Change Control, Issue Management, Quality Reviews, and Work Packages (all discussed under “The Strengths of PRINCE2”). None of these require “permission” from authorities outside the project, so they are easily implemented by the Project Manager. They can even be used by project teams or in sub-projects. As these approaches and techniques become accepted by stakeholders and others on the project, consider using other aspects of PRINCE2. Because of PRINCE2's integrated approach, if you use most of PRINCE2's approach to a specific piece in the first round, you can add features in almost a plug-and-play manner. Features like Project Boards can be powerful when implemented, but require greater buy-in and commitment from stakeholders to succeed—so put these off until greater interest is shown by management.

Use it as the proven, low-cost basis for your company's methodology. Get to know PRINCE2 and consider using it as the core of your company's new project management approach—perhaps along the lines of “PMBOK® Guide and PRINCE2 – Together”. Suggest it to management, selling it through its credibility wherever it has been implemented (internationally), and its open (no-fee) availability. Remind management that, when used in an integrated manner, it will support your company's fulfillment of any future “maturity” plans. Propose that a small group create a prototype project management methodology built around PRINCE2, to build understanding and to plan out how to integrate it into your organization's environment. (You can do research on how PRINCE2 has been used via the website of the accrediting body, the APM Group [www.apmgroup.co.uk]. They also have case studies on how to implement it.) Your core group should consider getting themselves accredited in PRINCE2, so you are all sure your team understands how to use it most effectively. (You will also become the Project Office/ resource team for all future work under PRINCE2.) Remember that you will need to bring big chunks of the PMBOK® Guide into this methodology to make it complete, so while you're learning about PRINCE2, think forward towards how you will combine the two. PRINCE2 doesn't have to be used “as-is”—though following “pure” PRINCE2 will help ensure that your company will meet later “maturity” accreditation requirements.

By using the PMBOK® Guide and PRINCE2 together you are taking advantage of the two most respected project management approaches in the world today, and are getting the best of both!

The author can be contacted at [email protected].
PRINCE2 is a registered trademark of the UK Government's Office of Government Commerce (OGC).PMBOK® Guide, PMI® and PMP® are registered trade and service marks of The Project Management Institute, Inc.

© 2004, Jay M. Siegelaub
Originally published as a part of 2004 PMI Global Congress Proceedings — Anaheim, California

Advertisement

Advertisement

Related Content

  • Project Management Journal

    Validation of a New Project Resilience Scale in the IT Sector member content locked

    By Rahi, Khalil | Bourgault, Mario This article aims to present the concept of project resilience and to validate, through quantitative analysis, to assess its two key dimensions: awareness and adaptive capacity.

  • Project Management Journal

    Navigating Tensions to Create Value member content locked

    By Farid, Parinaz | Waldorff, Susanne Boche This article employs institutional logics to explore the change program–organizational context interface, and investigates how program management actors navigate the interface to create value.

  • Project Management Journal

    Getting Past the Editor's Desk member content locked

    By Klein, Gary | Müller, Ralf To reach acceptance, every research paper submitted to Project Management Journal® (PMJ) must pass several hurdles. This editorial aims to declare the editorial process and reveal major reasons for…

  • Project Management Journal

    Investigating the Dynamics of Engineering Design Rework for a Complex Aircraft Development Project member content locked

    By Souza de Melo, Érika | Vieira, Darli | Bredillet, Christophe The purpose of this research is to evaluate the dynamics of EDR that negatively impacts the performance of complex PDPs and to suggest actions to overcome those problems.

  • Project Management Journal

    Coordinating Lifesaving Product Development Projects with no Preestablished Organizational Governance Structure member content locked

    By Leme Barbosa, Ana Paula Paes | Figueiredo Facin, Ana Lucia | Sergio Salerno, Mario | Simões Freitas, Jonathan | Carelli Reis, Marina | Paz Lasmar, Tiago We employed a longitudinal, grounded theory approach to investigate the management of an innovative product developed in the context of a life-or-death global emergency.

Advertisement
