Relationship between project governance and project performance

a multiple case study of shutdown maintenance projects in a maritime environment

Dr. Kaye Remington
Research Fellow, University of Technology Sydney

Clem Turner
Doctoral Candidate, University of Technology Sydney

Introduction

In corporate governance, the need for increased organizational and individual accountability has become obvious because of the failure of corporations to conduct business transactions in an ethical and responsible manner. Globally, governments have responded to major corporate and accounting scandals by enacting legislation: the U.S.'s Sarbanes-Oxley Act of 2002 (SOX), Australia's Corporate Law Economic Reform Program Act of 2004 (CLERP 9) and changes to The Companies Act 1985 in the UK, and European Union Directives (Turbit, 2005; Weaver, 2005). While corporate governance has a longer history: during the past decade, awareness of project governance has been increasing (Abednego & Ogunlana, 2006; Crawford & Cook-Davies, 2005; Hazard & Crawford, 2004; Miller, 2005; Pryke & Pearson, 2006; Turbit, 2005; Turner & Keegan, 2001).

Given that many high-profile projects have failed, it appears that some organizations are still experimenting with the concept of project governance and exploring its relationship to project performance. Therefore, there is a need for deeper understanding of what constitutes effective project governance.

Brief Literature Review

Corporate Governance

Corporate governance takes into account both internal controls and external corporate relationships. The approach to governance is critical in setting direction, monitoring performance and responding to external pressures.

Exhibit 1 summarizes the development of the theories of corporate governance in the Anglo-American countries, which influence Australian practice upon which this research focuses.

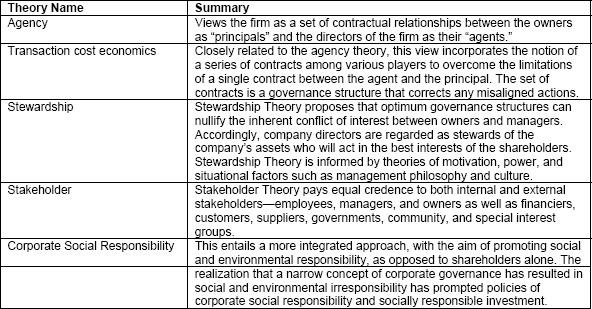

Development of Corporate Governance Theories

Exhibit 1 – Development of Corporate Governance Theories
Source: Clarke 2004, 2007; Mallin 2004, 2006

One of the effects of globalization is the drive towards convergence of corporate governance regulations around the world. While the Organisation for Economic Cooperation and Development (OECD) accepts that there is no single model of corporate governance, it developed a set of shared or common principles of corporate governance. OECD defined corporate governance as

a set of relationships between a company's management, its board, its shareholders, and other stakeholders. Corporate governance also provides the structure through which the objectives of the company are set, and the means of attaining those objectives and monitoring performance is determined. (OECD, 2004, p. 11)

In Australia, the Australian Securities Exchange's (ASX) Corporate Governance Council addressed issues of corporate governance (ASX, 2007). According to ASX, corporate governance is the

framework of rules, relationships, systems and processes within and by which authority is exercised and controlled in corporations. It encompasses the mechanisms by which companies, and those in control, are held to account. Corporate governance influences how the objectives of the company are set and achieved, how risk is monitored and assessed, and how performance is optimized. (ASX, 2007, p. 3)

While the OECD principles cover a company's responsibility towards stakeholders, the ASX seems to focus on the shareholders. The ASX principles also reflect the reaction to recent excesses of CEO compensation that has disaffected shareholders in Australia. Exhibit 2 shows a comparison between OECD's Corporate Governance Principles and Core Principles of Corporate Governance in Australia.

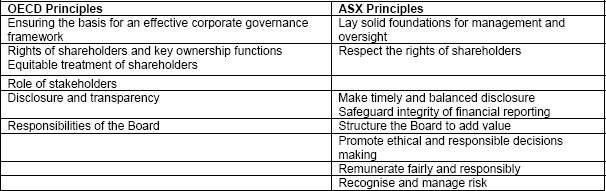

Relationship between OECD's Corporate Governance Principles and Core Principles of Corporate Governance in Australia

Exhibit 2 – Relationship between OECD's Corporate Governance Principles and Core Principles of Corporate Governance in Australia
Source: ASX 2007; OECD 2004

Does corporate governance leads to good performance? This is an important question in the light of recent corporate failures. Based on various studies carried out by banks, consultancies, and universities, the International Finance Corporation (IFC), an arm of the World Bank, stated that well-governed companies attract premium valuations in OECD and emerging market countries, make banks and rating agencies see companies in a better light, perform better due to improved operations, and have better access to IFC (IFC, 2007). However, Clarke (2007) and Mallin (2004) stated that despite a great deal of research, the evidence is not clear, and correlating performance to governance is not that straightforward.

Project Governance

Since the 1950s, project-based methods have emerged to deal with unique, novel, and transient operations (Bresnen, Goussevskaia, & Swan, 2005; Partington, 1996; Pellegrinelli, 1997; Turner & Keegan, 2001; Wickenberg, 2004). Yet it is only during the past decade that the awareness of project governance has been on the increase in both private and public sectors (Abednego & Ogunlana, 2006; Crawford & Cook-Davies, 2005; Hazard & Crawford, 2004; Miller, 2005; Pryke & Pearson, 2006; Turbit, 2005; Turner & Keegan, 2001). The project management literature on governance reveals that the term is used in a variety of ways and has a variety of meanings (APM GoPM Specific Interest Group, 2005; Crawford & Cook-Davies, 2005; Hazard & Crawford, 2004; Turbit, 2005). Governance is generally understood to encompass authority, accountability, stewardship, leadership, direction, and control (Australian Government, 2006). As a mode of organizing transactions, project governance presents as a multidimensional phenomenon, encompassing the initiation, termination, and maintenance of the ongoing relationships between a set of parties (Heide, 1994). From the literature on corporate and project governance there appear to be some common terms, such as accountability, authority, relationships, controlling, and monitoring.

However, governance is more than a controlling process. Rather, it presents as an authoritative oversight to monitor compliance, is influential in mitigating risk, and provides guidance and direction (Moldoveanu & Martin, 2001). Corporate governance can focus on ethical values and moral choices that honour the citizenship role of organizations (Caldwell, 2004). Project governance, on the other hand, is project-focussed, describing how the project management processes are governed throughout the project lifecycle (Truner & Keegan, 2001; White, 2001; Winch, 2001). Therefore one needs to consider whether there is a difference between project governance and project management.

Carver (2001) described the relationship as one of “governors” being in control and “managers” being optimally empowered. In addition, the governance function has a closer link to ownership than it has to management (APM GoPM Specific Interest Group, 2005; ASC, 2007; Carver, 2001). In general, governance could be thought of as establishing and employing power, subject to the overarching goal of coordinating actors' efforts (Heide, 1994) or in the context of projects, building consensus necessary to achieve an objective in an arena where many different interests are in play (de Alcantara, 1998). In the project environment, governance mechanisms are needed to support the operational control processes, and to manage the interface between project teams and their clients (Coles, McWilliams, & Sen, 2001; Henisz, 2006; Hyvari, 2006; Turner & Keegan, 2001). In other words, project governance provides the structure through which the objectives of the project are set, the means of attaining those objectives determined, and the means of monitoring performance are determined (Turner, 2006).

To that end, project governance may be viewed as the framework that enables the project management function to deliver the benefits of the project; and an assessment of the project performance leads to an understanding of the effectiveness of the project management.

Research Question

This study seeks to discover how project governance may contribute to project performance in a maritime project environment. It will do so by revealing where the concept of project governance is situated in the structure of the organization. Specifically, the study will explore the role of project governance in relation to the project performance of selected shutdown maintenance projects in a maritime environment. A set of sub-problems also requires investigation to help address the main research issue.

Research Methodology

A multiple case study methodology (Yin, 2003) will be used. Several projects from within the organization will be selected. Furthermore, in accord with Yin's (2003) characteristics of case study research, the study aims to go beyond simply exploring certain phenomena in selected shutdown maintenance projects to gaining an understanding of the phenomena within the context of a maritime environment.

Abednego's (2006) modified governance framework, Exhibit 3, is helpful in explaining the theoretical foundation for the research. Using deductive logic it is reasonable to infer a relationship between project governance (A) and project management (B), and a relationship may be inferred between project management (B) and project performance (C). Therefore, it is reasonable to hypothesize that a relationship also exists between project governance and project performance.

Theoretical relationship of the research

Exhibit 3 – Theoretical relationship of the research
Source: Adapted from Abednego, 2006

In summary, the intended research methodology for this project is:

  • Philosophy – Phenomenological (Interpretivist)
  • Approach – A mix of inductive and deductive
  • Strategy – Case Study
  • Time Horizon – Longitudinal
  • Data collection method – Secondary Data, Observations, Interviews, and Questionnaires

Characteristics of Case Study Environment

The case study at the focus of this research is an Australian public sector organization. It comprises five corporate divisions, each of which is divided into more than 20 business units known as system program offices. The business units are responsible for the acquisition of new maritime projects, as well as sustaining and supporting the firm's asset base. Under constant scrutiny, the importance of effective project governance to this organization and its agencies cannot be overemphasized. The research study will focus on one division, which has recently implemented a system of project governance to improve the planning and implementation of its shutdown maintenance projects. Project governance is a relatively new concept for this organization.

Researcher's Background

Since 2002, the researcher has filled two roles within the parent organization that is the focus of interest for this research. Firstly, as Superintendent Maintenance Engineering, he was accountable for the in-service support and sustainment of fixed and mobile heavy plant and machinery and, since 2004, he has been performing the role of Project Superintendent – Commissioning and Shutdown Maintenance. In this latter role, he is accountable for the end-to-end planning, procurement, production, and post-production phases for implementing shutdown maintenance of fixed and mobile heavy plant and machinery. He coordinates the efforts of 15–20 multi-functional and multi-disciplinary technicians, subject matter experts, sub-contractors, and junior engineers. The project length is typically 50 weeks and, depending on the maintenance cycle, the production period is either 4, 15, or 25 weeks. Project budgets can range from $AU3M to $AU20M.

An interest in project performance first developed in 1996 when he was accountable for implementing the parent organization's ship repair program in Western Australia. Following the parent organization's re-organization in 2003, one outcome was an increased focus on improving project performance and implementing project governance. This renewal initiative was the catalyst that began the researcher's journey to explore the relationship between project governance and project performance of ship repair and refit projects.

Some Initial Findings

Project Summary

The duration of shutdown maintenance projects selected for this case study is less than 50 weeks, which includes planning, production, commissioning, and closure. Every nine months there is a 4-week shutdown maintenance period and every 36 months there is a 15-week shutdown period for each of the system program office's (SPO) eight maritime assets. Five of the assets are in Perth and three in Sydney. Procurement of goods and services for the project's production is via a restricted tender process, which results in a fixed-price contract.

Project Environment

The planning and conduct of shutdown maintenance is a complex and expensive operation involving many stakeholders in a dynamic environment. So that the complexity and expense can be addressed in a uniform and replicable manner, the SPO's shutdown maintenance activities are managed as a project. In addition, the shutdown maintenance has to comply with the end user's technical regulatory system. Project management methodology version 2 (PMMv2) is the mandated methodology for these projects and it has been refined to meet the parent organization's particular circumstances.

At the top of the project governance structure, members of the asset repair and refit governance board operate out of Canberra and Sydney. The Project Executive Board (PEB) and elements of the Integrated Project Team (IPT) operate from the SPO in Perth. For the Sydney-based assets, the project superintendent, project manager, procurement specialists, logistics support, and end user operate locally. The production site for the Sydney assets can be Brisbane, Newcastle, Sydney, Melbourne, or Adelaide. The production phase for the assets in Western Australia is effected in Perth. The IPT is only physically collocated on-site when the project enters the production phase. During other project phases the team has virtual meetings online and communicates through emails and telephone conferencing. The Project Governance structure of shutdown maintenance projects is summarized in Exhibit 4.

Project Governance layer Description
Asset repair and refit governance board In the context of operational and technical requirements and industry capacity, the board provides strategic guidance and direction to the SPO. Sponsors the asset repair and refit policy.
Project executive board (PEB) Is comprised of the SPO director and representatives of the end user and logistics support groups. The asset's operations manager and other subject matter experts may also attend the PEB by invitation.
Responsibilities include overall leadership, control, and broad direction of repair and refit projects.
Project leadership team (PLT) This team is comprised of the deputies of the PEB and:
  • Facilitates project stakeholder involvement
  • Maintains oversight of the issue and risk management status
  • Ensures effective and complete closeout of individual projects, approval of post-project analysis, contract review, and project closure reports
  • Ensures implementation of lessons identified from projects and management of any follow-on actions
  • Maintains oversight of project assurance processes and outcomes
  • Manages continuous improvement of the overall repair and refit of project management processes
Project Superintendent Is appointed by the PEB and is accountable for:
  • Managing the IPT
  • Implementing the project management plan
  • Monitoring and controlling project risks and issues
  • Ensuring overall project performance
  • Ensuring technical compliance
  • Maintaining resource requirements
Integrated Project Team Is made up of representatives from the stakeholder organizations – these are full-time positions seconded for the period of the project and include a project manager, maintenance planner, project stores coordinator, contract manager, maintenance manager, in-service support representatives, and quality control and compliance manager.

Table 3 – Project governance structure for shutdown maintenance projects
Source: developed for this research

Some Initial Observations of the SPO's Project Governance

Complexity in governing the project's operations derives from lines of communication, which are very complicated and difficult to understand, and can be described as almost chaotic. Some parts of the parent organization and the SPO are arranged around matrix lines, other areas have flatter structures. The project's planning phase is well structured and well documented; role clarity is documented and understood. Project implementation commences with the procurement cycle. Here the policy is well structured but the implementation of the policy is complicated because of overlapping of roles, a proliferation of roles, and a lack of propensity to think beyond the immediate area of responsibility. There is a “need-to-know” mindset because of commercial issues and a disinclination to share information. The regional contracts manager (this is a bottleneck) controls information distribution—this issue will be resolved when the function is absorbed by the SPO. At the production phase, the losing line managers for some members of the IPT are unenthusiastic to release control of their people to the project superintendent.

Some roles are duplicated and, in some areas, effective use of the delegations is not taking place. Power (control) distribution is disjointed—roles, which should have authority, do not necessarily have the authority commensurate with their role in the project—accountability is ambiguous. For example, the project superintendent is accountable for the project outcomes but has no financial or technical delegation. Contract administration and contract management rests with the project manager, who reports to the project superintendent, and matters beyond the project manager's financial delegation are elevated to the Planning and Liaison Team for approval. This situation is a result of the project superintendent being an external consultant and although there is a policy in place that makes provision for consultants to have financial delegation, the policy is not enacted.

When Things Go Wrong, Where Do They Go Wrong?

This is best described in the context of the project's administrative functions. Authority for operational tasks (deciding what projects should be done and when) is at the tactical level (the Project Execution Board); the project superintendent has no control or authority over the approval and phasing of projects. Although the project superintendent has some input, the authority for executive tasks (deciding who carries out the tasks and how) rests at the functional levels within the SPO. Likewise, while the project superintendent only assists functional managers in coordinating interdepartmental decisions, authority for resource maintenance tasks (procurement and maintenance of departmental resources both people and material) resides at the functional level within the Systems Project Office.

Therefore, things tend to go wrong when:

  1. Actors are seconded to the project team and their line managers still control the actor's contribution to the project—line managers govern the scope of effort for some team members. This creates a source of conflict between the project superintendent and the line manager.
  2. Some stakeholders do not recognize the delegated authority of the project superintendent.
  3. Some actors do not make themselves aware of their obligations (the obligations which their management have signed up to) under the project charter.
  4. Actors continue to operate in a “business-as-usual” paradigm.

Notwithstanding this, in a recent shutdown maintenance project with a production phase of 26 weeks, assessment of the project's success and the project management's success was favourable. The asset's baseline capability was restored and the asset started its operational cycle as planned. However, the variables that might account for a perception of success in such a project are many. Project management success might have been related to other factors, such as the high motivation levels and experience of the project staff involved or the level of quality control applied to production tasks. These other factors may serve to mask any inadequacies in the governance structure, especially impacts that might result from the complex communication structure. Theoretically, a governance structure should be robust enough to support less experienced as well as highly experienced project staff. An investigation that explores all of these interrelated contributing factors will contribute to a more detailed understand of the role of the governance structure in these kinds of projects.

Conclusions

To our knowledge, few researchers have explored the relationship between project governance and project performance by examining the relationship between project governance and management and project management and performance. A multiple case study method will be used to discover how project governance may contribute to project performance in a maritime project environment. It will do so by revealing where the concept of project governance is situated in the structure of the organization. Specifically, the study will explore the role of project governance in relation to the project performance of selected shutdown maintenance projects in a maritime environment of an Australian public organization.

References

Abednego, M. P., & Ogunlana, S. O. (2006). Good project governance for proper risk allocation in public-private partnerships in Indonesia. International Journal of Project Management, 24(7), 622–634.

APM GoPM Specific Interest Group. (2005.) Directing change, a guide to governance of project management (2nd ed.). High Wycombe, UK: Association for Project Management.

Australian Government. (2006). Defence annual report 2005–06 (Volume Two). Canberra: Department of Defence.

ASX (Australian Stock Exchange). (2007). Corporate governance principles and recommendations (2nd ed.). Sydney, NSW: Australian Stock Exchange.

Bresnen, M., Goussevskaia, A., & Swan, J. (2005). Implementing change in construction project organizations: Exploring the interplay between structure and agency. Building Research and Information, 33(6), 547–560.

Caldwell, C. (2004). Effective governance in managing change – Common perspective from two lenses. Academy of Management Review, 29(2), 296.

Carver, J. (2001). A theory of governing the public's business – Redesigning the jobs of boards, councils, and commissions. Public Management Review, 3(1), 53–72.

Clarke, T. (ed.). (2004). Theories of corporate governance: The philosophical foundations of corporate governance. London: Routledge.

Clarke, T. (2007). International corporate governance: a comparative approach. London: Routledge.

Coles, J. W., McWilliams, V. B., & Sen, N. (2001). An examination of the relationship of governance mechanisms to performance. Journal of Management, 27(1), 23–50.

Crawford, L. H., & Cook-Davies, T. J. (2005). Project governance: The pivotal role of the executive sponsor. Proceedings of PMI North America. Toronto: Project Management Institute.

de Alcantara, C. H. (1998). Uses and abuses of the concept of governance. International Social Science Journal, 50(155), 105–113.

Hazard, V., & Crawford, L. (2004). Defining project governance. Proceedings of ProMAC Research Conference. Tokyo, Japan.

Heide, J. B. (1994). Interorganizational governance in marketing channels. Journal of Marketing, 58(1).

Henisz, W. J. (2006). Governance issues in public private partnerships. International Journal of Project Management, 24(7), 537–538.

Hyvari, I. (2006). Project management effectiveness in project-oriented business organizations. International Journal of Project Management, 24(3), 216–225.

IFC. (2007). The irresistible case for corporate governance. Retrieved on November 18, 2007 from www.ifc.org/ifcext/pepse.nsf/AttachmentsByTitle/IrresistibleCase4CG.pdf/$FILE/IrresistibleCase4CG.pdf

Mallin, C. A. (2004). Corporate governance. Oxford: Oxford University Press.

Mallin, C. A. (ed.). (2006). Handbook of international corporate governance. Cheltenham: Edward Elgar.

Miller, R. (2005). Governance regimes for large complex projects. Project Management Journal, 36(3), 42–50.

Moldoveanu, M., & Martin, R. (2001). Agency theory and the design of efficient governance mechanisms. Toronto: Joint Committee on Corporate Governance, University of Toronto.

OECD (Organisation for Economic Cooperation and Development). (2004). Principles of corporate governance. Paris: OECD Publications.

Partington, D. (1996). The project management of organizational change. International Journal of Project Management, 14(1), 13–21.

Pellegrinelli, S. (1997). Programme management: Organising project-based change. International Journal of Project Management, 15(3), 141–149.

Pryke, S. D., & Pearson, S. (2006). Project governance: Case studies on financial incentives. Building Research and Information, 34(6), 534–545.

Turbit, N. (2005). IT governance and project governance, Project Perfect. Retrieved on September 27, 2006 from www.projectperfect.com.au

Turner, J. R. (2006). Towards a theory of project management: The nature of the project governance and project management. International Journal of Project Management, 24(2), 93–95.

Turner, J. R., & Keegan, A. (2001). Mechanisms of governance in the project-based organization: Roles of the broker and steward. European Management Journal, 19(3), 254–267.

Weaver, P. (2005). Effective project governance – A cultural sea change. PMI Global Congress – Asia Pacific, Singapore, http://knowledgebase.pmi.org/content/frame.htm

White, L. (2001). Effective governance through complexity thinking and management science. Systems Research and Behavioural Science, 18, 241–257.

Wickenberg, J. (2004). Exploring the shadows of project management. PhD thesis, Sweden: Chalmers Tekniska Hogskola.

Winch, G. M. (2001). Governing the project process: A conceptual framework. Construction Management & Economics, 19(8), 799–808.

Yin, R. K. (2003). Case study research design and methods (3rd ed.). Thousand Oaks, CA: Sage Publications.

This material has been reproduced with the permission of the copyright owner. Unauthorized reproduction of this material is strictly prohibited. For permission to reproduce this material, please contact PMI or any listed author.

© 2008, Sankaran, Remington & Turner
Originally published as part of 2008 PMI Global Congress Proceedings – Sydney, Australia

Advertisement

Advertisement

Related Content

  • Project Management Journal

    The Organizational Design of the Project-Based Organization member content locked

    By Turner, J. Rodney | Miterev, Maxim This article investigates organizational design choices and their antecedents for the design of project-based organizations. Extant literature acknowledges the diversity of project-based…

  • Project Management Journal

    Modeling Organizational Project Management member content locked

    By Müller, Ralf | Drouin, Nathalie | Sankaran, Shankar The contemporary discourse on organizational project management (OPM) complements project, program, and portfolio management with emerging elements, such as governance, projectification, the project…

  • Project Management Journal

    Governmentality member content locked

    By Clegg, Stewart Project governance that includes multiple firms and other agencies is more complex than the corporate governance of a single firm or organization. First, there is no necessary alignment between the…

  • Project Management Journal

    Projects in the Business Ecosystem member content locked

    By Eriksson, Kent | Wikström, Kim | Hellström, Magnus | Levitt, Raymond E. This article develops a conceptual framework to analyze the governance of projects within a business ecosystem. The framework is applied to the case of a vessel delivery project in the short sea…

  • PM Network

    Empathic Problem-Solvers registered user content locked

    By Mustafa, Abid As the digital revolution continues to sweep through organizations, there is a real danger that enterprise project management offices (EPMOs) will be left behind. EPMOs traditionally have excelled…

Advertisement

Publishing or acceptance of an advertisement is neither a guarantee nor endorsement of the advertiser's product or service. View advertising policy.
